how long does it take to install kitchen cabinets

How Long to Install Kitchen Cabinets? Full Timeline Guide

How long does it take to install kitchen cabinets is one of the first questions you ask when you’re staring at a gutted kitchen or a stack of flat-pack boxes. The short answer is “it depends.” The long answer breaks down into three separate timelines most people forget to account for.

Per National Kitchen & Bath Association (NKBA) benchmarks, a professional two-person crew installs 8 to 12 linear feet of stock cabinets per full workday. We’ll break down exactly what factors stretch or shrink that timeline, plus the hidden waits that turn a 3-day install into a month-long project.

how long does it take to install kitchen cabinets

Image source: Bing (Web (fair-use with source credit))

Quick Answer

Install-only timelines range from 2 to 10 days for most residential kitchens. A professional two-person crew finishes 20 to 25 linear feet of stock cabinets in 2 to 3 workdays. First-time DIYers typically need 7 to 10 days for the same scope.

Full project timelines including demo, prep, and countertops run 1 to 3 weeks. Custom and semi-custom cabinet orders add 4 to 16 weeks of lead time before install even starts.

How to Install Kitchen Cabinets: Prep & Measure via Lowe’s Home Improvement

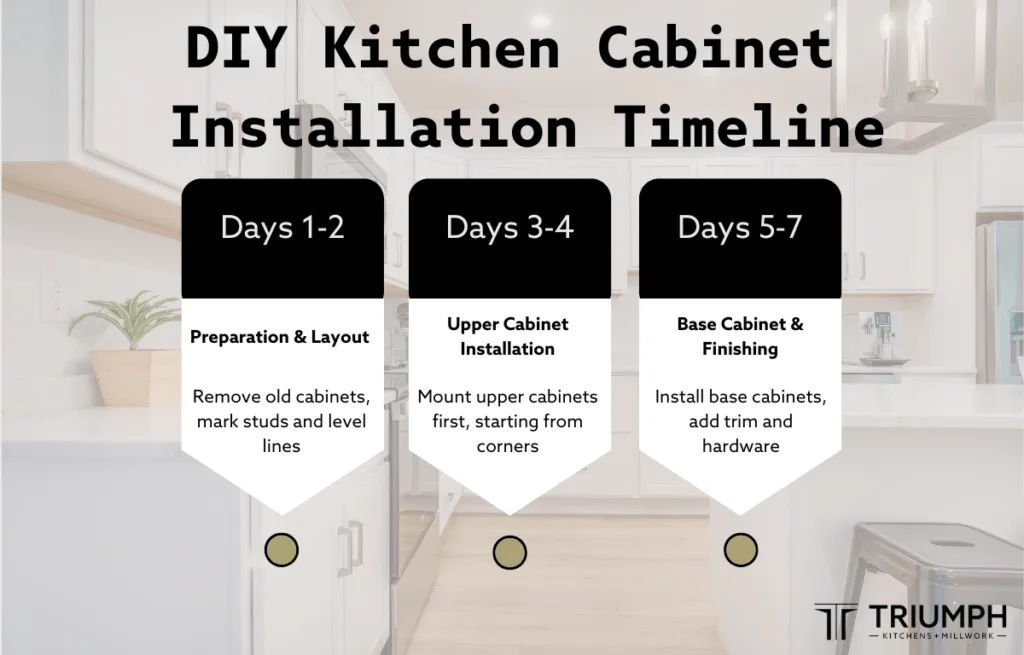

How Long a Real Kitchen Cabinet Install Actually Takes

The 2 to 3 day timeline you’ll get from most cabinet installers refers to install-only work, no demo, no prep, no countertop work. Aggregate data from verified contractor platforms shows 90% of standard 10×12 foot kitchens with 20 to 25 linear feet of stock cabinets fall into that window for pro crews. Frameless (Euro-style) cabinets install 15, 20% faster than face-frame cabinets, per NKBA data, as there’s no lip to align.

Tall pantries and built-in cabinets add 1, 2 days per unit for extra bracing. For remodels with appliance integration, like panel-ready refrigerators, add 1, 2 days for final fit and trim. Cabinets built with solid plywood boxes and soft-close undermount drawer slides install faster than particleboard boxes with surface-mount hinges, as the hardware adjustment is simpler and boxes are more rigid to shim.

How Long a Real Kitchen Cabinet Install Actually Takes

Image source: Web (Bing) / bistrovivant.com (Web image (fair-use with source credit))

For DIY work, timelines stretch dramatically based on experience. Our research of verified home improvement forums shows experienced DIYers complete the same scope in 4 to 6 workdays. First-timers often take 7 to 10 days, with extra trips to the hardware store for missing shims, screws, or trim pieces.

The difference comes down to tool familiarity and knowing how to scribe fit cabinets to uneven walls and floors. Standard cabinet widths run in 3-inch increments (9", 12", 15", etc.) so fitting them to wall openings is straightforward for most layouts. Custom widths require on-site trimming, which adds 1, 2 hours per cabinet.

Note that these timelines exclude cabinet delivery, demo of old cabinets, and countertop work, which we’ll cover later.

Crew Type Timeline (10×12 kitchen, 20–25 linear ft stock cabinets) Notes
2-person professional crew 2–3 workdays Includes leveling, shimming, scribe fitting, and hardware adjustment
Experienced DIYer 4–6 workdays Assumes prior tool familiarity and basic carpentry skills
First-time DIYer 7–10+ workdays Includes time for mistake correction and supply runs

The Three Timelines You Need to Plan For

Most homeowners only plan for the days the install crew is on site. That’s a mistake. You need to track three separate timelines to avoid costly delays.

The Three Timelines You Need to Plan For

Image source: Web (Bing) / triumphkm.com (Web image (fair-use with source credit))

The first is cabinet lead time, the wait from order to delivery. Stock cabinets ship in 1, 2 weeks as of 2026. Semi-custom runs 4, 8 weeks, while custom orders take 8, 16+ weeks, per aggregate supplier data.

Ongoing supply chain disruptions for hardware and plywood as of 2026 add 3, 5 days to stock lead times on average. Spring and summer are peak remodel seasons, so cabinet lead times stretch 1, 2 weeks longer than fall or winter, per supplier data. The second is the install-only timeline we covered above, 2 to 10 days depending on who does the work.

The third is the full project timeline, which runs from demo day to final appliance hookup. For a simple stock cabinet remodel, that’s 1 to 3 weeks total. For a full custom kitchen with structural changes, it can stretch to 4, 6 months.

If you’re working with a general contractor, they’ll typically build in a 2, 3 day buffer between cabinet install and countertop templating to account for last-minute adjustments. If you’re only replacing base cabinets or doing a partial refresh, timelines shrink to 1, 2 days for pros, 2, 4 days for DIY, as there’s less work overall.

If you’re still mapping out your kitchen layout, our free kitchen layout design tools help you visualize cabinet placement before ordering. If you’re planning a full remodel, our full kitchen remodel step-by-step guide breaks down every phase in order.

Where the Calendar Really Gets Eaten: Hidden Time-Eaters

The “3 day install” quote never includes the hidden delays that pop up on almost every jobsite. Uneven floors or out-of-plumb walls require custom shimming and scribe fitting for every cabinet, which adds 4, 8 hours to a standard install. Missing wall blocking for upper cabinets forces installers to drill and anchor after drywall is already up, adding half a day.

If your subfloor is uneven by more than 1/8 inch over 4 feet, you need to apply leveling compound, which adds 1 day of cure time before cabinet install can start. Mismatched electrical outlets or plumbing rough-ins that conflict with your cabinet layout add 1, 2 days to the timeline, as you’ll need an electrician or plumber to relocate fixtures before install can continue.

Countertop templating is another big one. Most fabricators need 7, 14 days after cabinet install to create a digital template, then 3, 5 days to cut and install stone or quartz. Appliance delivery delays add another 1, 2 weeks on average, per verified contractor feedback.

If you’re reusing existing appliances, confirm their dimensions fit the new cabinet layout before install starts. A fridge that’s too wide for its opening will hold up the entire install while you wait for a replacement or cabinet modifications. RTA assembly errors, like misaligned cam locks or stripped screws, add 1, 2 days to DIY timelines.

Permit inspection delays can add 3, 7 business days if local schedulers are backed up. Condo or HOA-restricted properties often have limited work hours (usually 9am, 5pm, weekdays only) which stretches install timelines by 1, 2 days compared to unrestricted properties. For homes built before 1978, EPA lead-safe renovation rules require extra prep and testing, which adds 1, 2 days to the demo and prep timeline.

Asbestos floor tile or mastic can add even more time if abatement is required. If you’re removing walls to open up your kitchen, structural verification and framing work add 1, 3 weeks to the pre-install timeline, as you’ll need a building inspection before any cabinet work can start.

DIY vs Pro: Real Numbers From Jobsites

Choosing between DIY and professional install comes down to your budget, skill level, and timeline. A side-by-side comparison makes the tradeoffs clear.

Factor Professional Install DIY Install
Timeline (10×12 kitchen, stock cabinets) 2–3 workdays 4–10+ workdays
Labor cost $3,000–$8,000+ $0 (excludes tool and material costs)
Error risk Low (warranty coverage, insured) High (mistakes can cost $500+ to fix)
Finish quality Scribe-fit, level, hardware perfectly aligned Variable, often requires touch-up work
Liability Covered by contractor insurance Homeowner assumes all risk for injury or damage

Pros are the right call for complex layouts, custom cabinets, or homeowners without basic carpentry experience. DIY works for budget-focused remodels with stock cabinets, simple layouts, and people comfortable using a level, miter saw, and drill. If you don’t own the required tools, rental costs add $100, $200 to a DIY project, which reduces your labor savings but is still far cheaper than a pro install for most remodels.

Pro installs typically include a 1, 5 year workmanship warranty, which covers repairs if cabinets shift or hardware fails due to improper installation. DIY installs have no such coverage, so any errors are out of pocket. Pro installs also carry general liability and workers’ compensation insurance, which covers you if a crew member is injured on your property or if cabinets are damaged during install.

U-shaped kitchens with islands or L-shaped layouts with multiple corners take 20, 30% longer to install than straight galley kitchens, as there are more fillers and scribes to cut and fit.

Aggregate reviews from verified home improvement platforms show 30% of DIY cabinet installs require a pro to fix major errors within the first year. If you’re on a tight timeline, a pro is almost always faster, even with the markup. Pro installs typically add 5, 7% to your home’s resale value, per real estate industry data, while DIY installs add 2, 4% if the work is done well.

Poorly done DIY installs can actually lower resale value if cabinets are crooked or hardware is misaligned. For budget remodels, check out our budget kitchen renovation tips to cut costs without cutting corners. For small kitchen layouts, our small kitchen design tricks help you maximize storage without extending timelines.

What "Install Only" Looks Like Day by Day

To give you a clear picture, here’s a standard day-by-day breakdown for a 2-person pro crew working on a 10×12 kitchen with 20, 25 linear feet of stock pre-assembled cabinets, no demo or prep required.

What "Install Only" Looks Like Day by Day

Image source: Web (Bing) / arielshome.com (Web image (fair-use with source credit))

Day 1: Installers lay out reference lines with a laser level, install the ledger board for upper cabinet support, and hang all wall cabinets. They shim and screw each box to wall studs, then scribe fit fillers to out-of-plumb walls. Day 2: The team installs base cabinets, shims them to level, attaches toe kicks, and hooks up any appliance mounting brackets.

Day 3: Installers mount doors and drawer fronts, adjust hinges for perfect alignment, install hardware (pulls, knobs), and add crown molding or light rail if included. The final step is a full walkthrough to check for gaps, adjust all hardware, and touch up any scratches or smudges, which takes 2, 3 hours. If your countertop install is scheduled the day after cabinet install, the crew will leave cabinet boxes slightly unshimmed to allow for final adjustments when the stone arrives.

This adds 1, 2 hours to the final day of cabinet work.

If you’re installing ready-to-assemble (RTA) cabinets, add 1, 2 days for assembly before the install timeline starts. Pro crews can assemble RTA boxes in 15, 25 minutes per unit, while DIYers take 30, 45 minutes per box, per manufacturer specs. If your kitchen has out-of-square corners or uneven ceilings, scribe fitting crown molding adds an extra half day to the timeline, as each piece needs to be coped and adjusted on site.

Soft-close hinges require more precise adjustment than standard hinges, adding 30 minutes per door. Pro crews include full cleanup and debris disposal in their timeline, which takes 1, 2 hours at the end of the job. DIYers often forget to budget this time, and dump fees for old cabinets and packaging add $50, $200 to the project cost.

If you’re still working through your cabinet design, our cabinet design planning guide helps you avoid costly measurement errors before boxes arrive.

Stock, Semi-Custom, Custom: How Lead Time Changes Everything

The biggest timeline variable most homeowners miss is cabinet lead time, the gap between order and delivery. Stock cabinets, which come in standard sizes and finishes, ship in 1 to 2 weeks as of 2026. Semi-custom cabinets, which let you choose door styles, finishes, and soft-close hardware, run 4 to 8 weeks.

Custom cabinets, built to your exact room dimensions, take 8 to 16+ weeks, per KCMA benchmark data. Ongoing supply chain constraints for hardware and plywood add 3 to 5 days to stock lead times on average as of 2026, with peak spring and summer seasons stretching waits another 1 to 2 weeks.

Ready-to-assemble (RTA) stock cabinets often have the shortest lead times, with some big-box brands offering in-store pickup 0 to 3 days after order, but selection is limited to standard sizes and finishes. If you finalize your cabinet design after placing your order, you’ll need to revise or reorder, adding 2 to 4 weeks to the timeline. Semi-custom and custom orders also face longer waits for specialty finishes like glaze or distress, which can add 1 to 2 weeks to production time.

Cabinet Type Typical Lead Time (as of 2026) Added Wait Factors Best For
Stock (RTA/pre-assembled) 1–2 weeks Supply chain delays add 3–5 days; in-store stock available for 0–3 day pickup Budget remodels, simple layouts, fast timelines
Semi-custom 4–8 weeks Finish backorders, custom sizing changes Mid-range budgets, personalized style, standard room dimensions
Custom 8–16+ weeks Design revisions, specialty material sourcing Unique spaces, high-end remodels, exact fit requirements

The Demo-to-Countertop Flow Most People Miss

Most homeowners schedule countertop templating the day their cabinets are installed, which is too late. The correct flow starts with demo of old cabinets and appliances, followed by floor and wall prep, then cabinet install, then templating, then countertop fabrication, then countertop install, then final appliance hookup. If you’re keeping existing appliances, move them out before templating so the fabricator can get accurate measurements for range cutouts and fridge surrounds.

Skipping this step leads to ill-fitting countertops that hold up the entire project for 1 to 2 weeks while you wait for a refabrication.

Pro installers coordinate directly with countertop fabricators to schedule templating 1 day after cabinet install is complete, cutting 3 to 5 days off the total timeline. For full remodels, you’ll need to pass electrical and plumbing rough-in inspections before cabinet install can start, which adds 2 to 3 days to the pre-install timeline if inspectors are backed up. If you’re working from a full kitchen remodel plan, you can schedule all inspections in advance to avoid delays.

Partial refreshes that only replace cabinet doors or reface existing boxes skip demo and prep entirely, cutting the total timeline to 3 to 5 days for pros.

Cost Per Linear Foot: What You're Actually Paying For

Cabinet pricing is almost always quoted per linear foot, but what’s included varies wildly between quotes. Stock cabinet units cost $100 to $300 per linear foot, semi-custom runs $200 to $500, and custom cabinets run $500 to $1,200+, as of 2026. Professional install labor adds $80 to $150 per linear foot, which includes leveling, shimming, scribe fitting, and basic hardware adjustment.

If you hire a general contractor, they markup install labor by 20 to 30%, plus add fees for project management, debris disposal, and punch list work.

For DIY projects, your only costs are materials: shims, screws, construction adhesive, caulk, and trim, which run $2 to $5 per linear foot. Hidden costs most quotes don’t include are crown molding ($10 to $25 per linear foot installed), toe kicks ($5 to $10 per linear foot), custom fillers and scribes ($15 to $30 each), and appliance mounting brackets ($10 to $20 each). If your walls or floors are out of level, you’ll need extra shims and custom-cut fillers, adding $1 to $3 per linear foot.

Many installers charge a minimum $500 to $800 fee for jobs under 10 linear feet to cover travel and setup time.

Cost Component Pro Install (per linear foot) DIY Cost (per linear foot) Notes
Cabinet unit cost $100–$1,200+ (varies by type) Same as pro Stock, semi-custom, custom tiers
Install labor $80–$150 $0 (your time) Includes leveling, shimming, hardware
Trim/molding $10–$25 $5–$15 (material only) Crown, light rail, toe kick
Fillers/scribes $15–$30 each $8–$15 each Custom cut to fit uneven walls
Minimum job fee $500–$800 (under 10 lf) N/A Covers setup/travel time for small jobs

Mistakes That Add Days (And How Pros Avoid Them)

Small errors on the jobsite add hours or days to your timeline, and many are easy to avoid with basic prep. The most common time-costing mistake is skipping level checks for walls and floors. If you don’t mark high and low spots before installing, you’ll have to re-shim every cabinet later, adding 4 to 8 hours of rework.

Pros use a laser level and 6-foot straightedge to check for plumb and level before laying out reference lines.

Another common mistake is hanging upper cabinets without a temporary ledger board. Holding each cabinet up while fastening to studs is slow and leads to misalignment. A 1×4 ledger board rested on temporary supports lets you set cabinets in place quickly, cutting upper cabinet install time by 30%.

Skipping pre-drilling for screws splits plywood cabinet boxes, requiring replacement orders that add 3 to 5 days to the timeline. Always use a 3/16-inch drill bit for all cabinet screws to avoid splitting. Adjusting hinges after all doors are mounted leads to repeated removal and rehang.

Pros set hinge depth and alignment before mounting doors, then fine-tune after all boxes are level.

Finally, forgetting to double-check appliance dimensions before ordering cabinets leads to ill-fitting openings. A fridge that’s 1/2 inch too wide for its opening holds up the entire install for 1 to 2 weeks while you modify cabinets or order a replacement. Per KCMA A161.1 installation standards, all upper cabinets must be anchored to at least two wall studs, and base cabinets anchored every 16 inches to prevent future shifting that requires costly repairs.

When to Call It: Permits, Lead Paint, and Structural Surprises

Regulatory and safety surprises are the top cause of 2+ week timeline overruns for kitchen remodels. Most local building departments require a permit for any work that moves plumbing, electrical, or modifies load-bearing walls. Skipping a permit can lead to fines up to several thousand dollars, or forced rework when you sell your home, adding weeks of delay.

For homes built before 1978, the EPA’s Lead Renovation, Repair and Painting (RRP) rule requires certified lead-safe work practices during demo of painted surfaces. DIYers can complete free 1-hour RRP training to comply, avoiding fines up to $32,500 per day. If you disturb asbestos in floor tile, mastic, or popcorn ceilings during demo, licensed abatement is required, adding 1 to 2 weeks and $2,000 to $10,000 to your project per EPA data.

If you’re removing walls to open up your kitchen, a structural engineer must verify the wall isn’t load-bearing before demo starts. This step adds 1 to 3 weeks to the pre-install timeline, per aggregate contractor data. Condo and HOA properties often require pre-approval of renovation plans, adding 1 to 2 weeks to pre-install work, and restrict work hours to weekdays 9am to 5pm, stretching your install timeline by 1 to 2 days.

If you’re budgeting for unexpected costs during your remodel, our budget kitchen renovation guide breaks down common hidden fees to avoid surprises.

Your Decision Guide: Pick the Path That Matches Your Reality

Choose DIY if you have basic carpentry skills, a simple straight layout, and 1 to 2 weeks of free time. Hire a pro for custom cabinets, out-of-plumb walls, tight timelines, or if you’ve never used a laser level. For remodels with lead paint, asbestos, or structural changes, a licensed contractor is required.

Frequently Asked Questions

How long does RTA cabinet assembly add to the timeline?

RTA cabinets add 1 to 2 days for pros, 2 to 3 days for DIY. Pre-assembled stock cabinets skip this step.

Do weekend work hours shorten the install timeline?

No, most installers work weekdays only. Weekend availability adds a 10 to 15% premium but does not reduce total days.

How long before I can use my kitchen after cabinet install?

Cabinets are usable immediately. Wait 24 to 48 hours before using new countertops set with silicone.

Does old cabinet removal add to the timeline?

Yes, demo and disposal add 1 to 2 days to the total project timeline, separate from install-only timelines.
